Montauban Project

KEY HIGHLIGHTS

MONTAUBAN OVERVIEW

The Montauban Project is ESGold’s flagship gold-silver development asset located in Québec, Canada. The project is designed as a fully permitted tailings-to-cash operation, recovering gold, silver, and mica from historic mine tailings while advancing district-scale exploration potential across the surrounding Montauban mining camp.

The project is advancing toward near-term gold and silver production and is supported by completed infrastructure, strong Preliminary Economic Assessment economics, and a newly defined geological model indicating a much larger mineralized system beneath the historic mine footprint.

Fully permitted and fully funded to commissioning and first production
Mill building completed with 1,000 tonnes per day processing capacity
Expanded ANT-2 survey and updated property-scale 3D geological model completed across approximately 70 km²
Integrated geological database includes 1,637 drillholes and 1,707 regional
multi-element samples

Expanded land position to 485 claims covering approximately 244 km² (24,414 hectares)

Montauban combines near-term production from historic tailings with district-scale exploration upside, creating a development pathway that can generate cash flow while expanding the broader mineral system.

WHY ESGOLD

The Montauban project is located in Montauban Township in Portneuf County, Québec, approximately:

• 80 km from Québec City • 60 km from Trois-Rivières
Québec consistently ranks among the most attractive mining jurisdictions globally due to political stability, transparent permitting frameworks, and extensive infrastructure.

Low-cost hydroelectric power

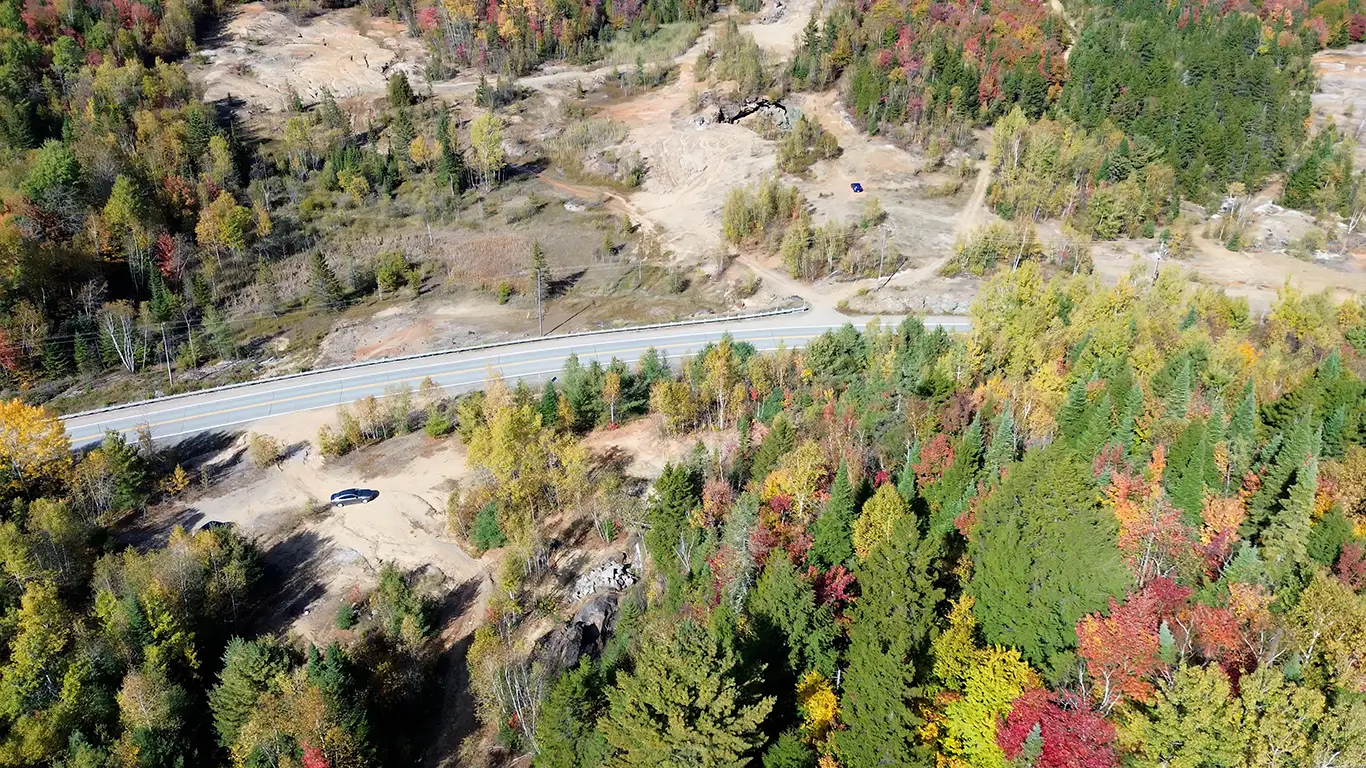

Existing road access

Proximity to skilled mining labour

Established mining infrastructure

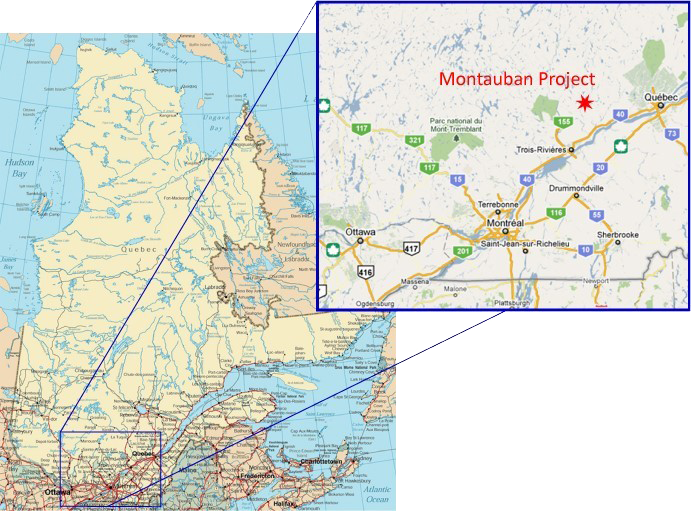

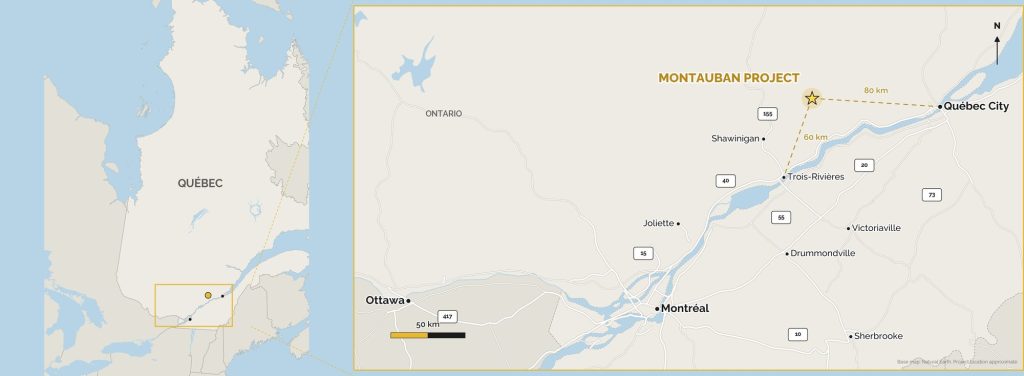

Location map of the Montauban Gold-Silver Project in Quebec, Canada

OUR MODEL

TAILINGS-TO-CASH

Montauban is built around ESGold’s tailings-to-cash model, which converts historic mine waste into revenue-generating mineral production.

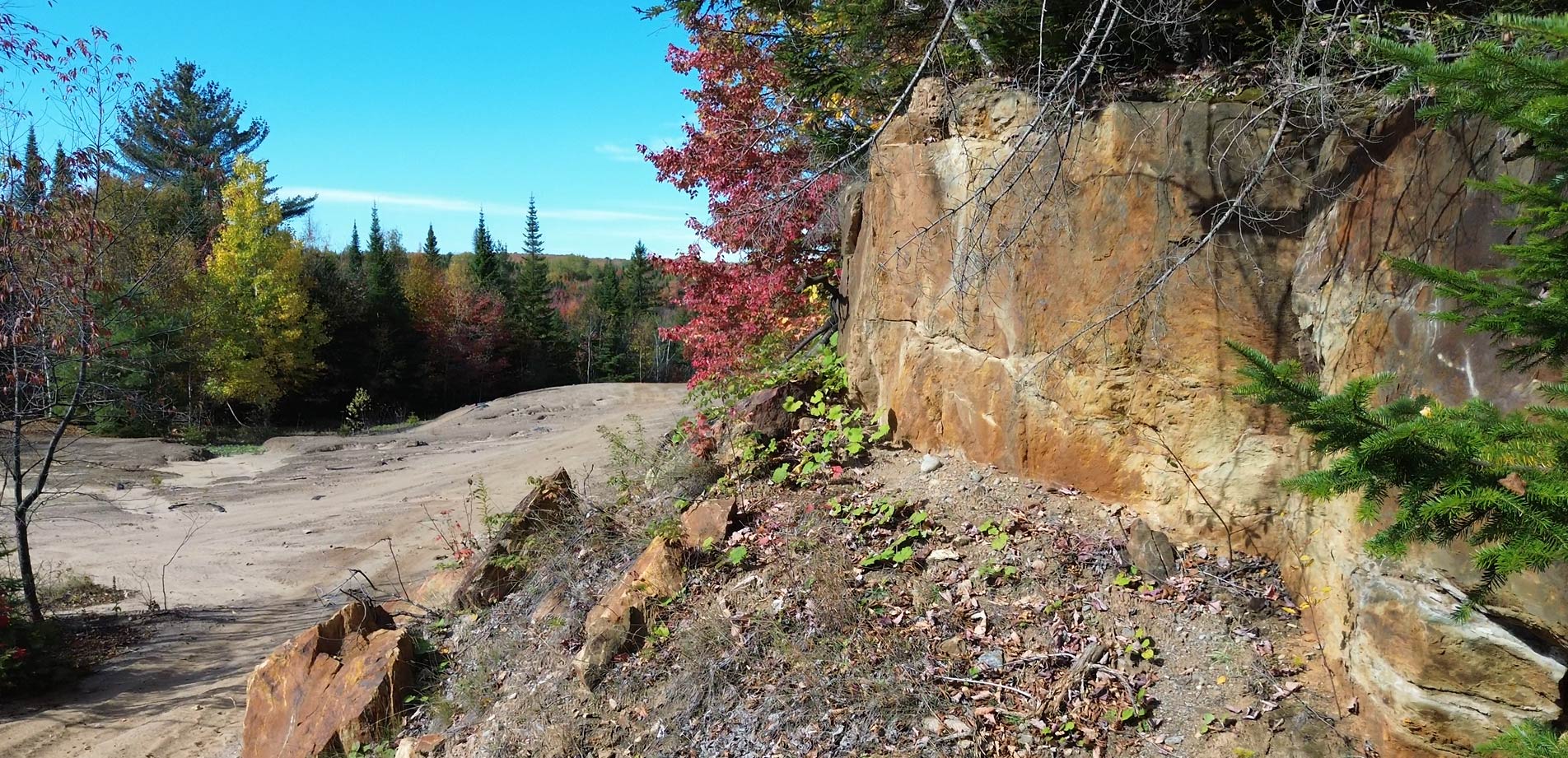

Historic operators left large volumes of tailings containing recoverable gold, silver, and mica. ESGold’s processing facility is designed to extract this remaining value while stabilizing and neutralizing legacy mine waste.

The model creates a self-funding development strategy..

This approach reduces reliance on capital markets and allows exploration to be funded through internal revenue.

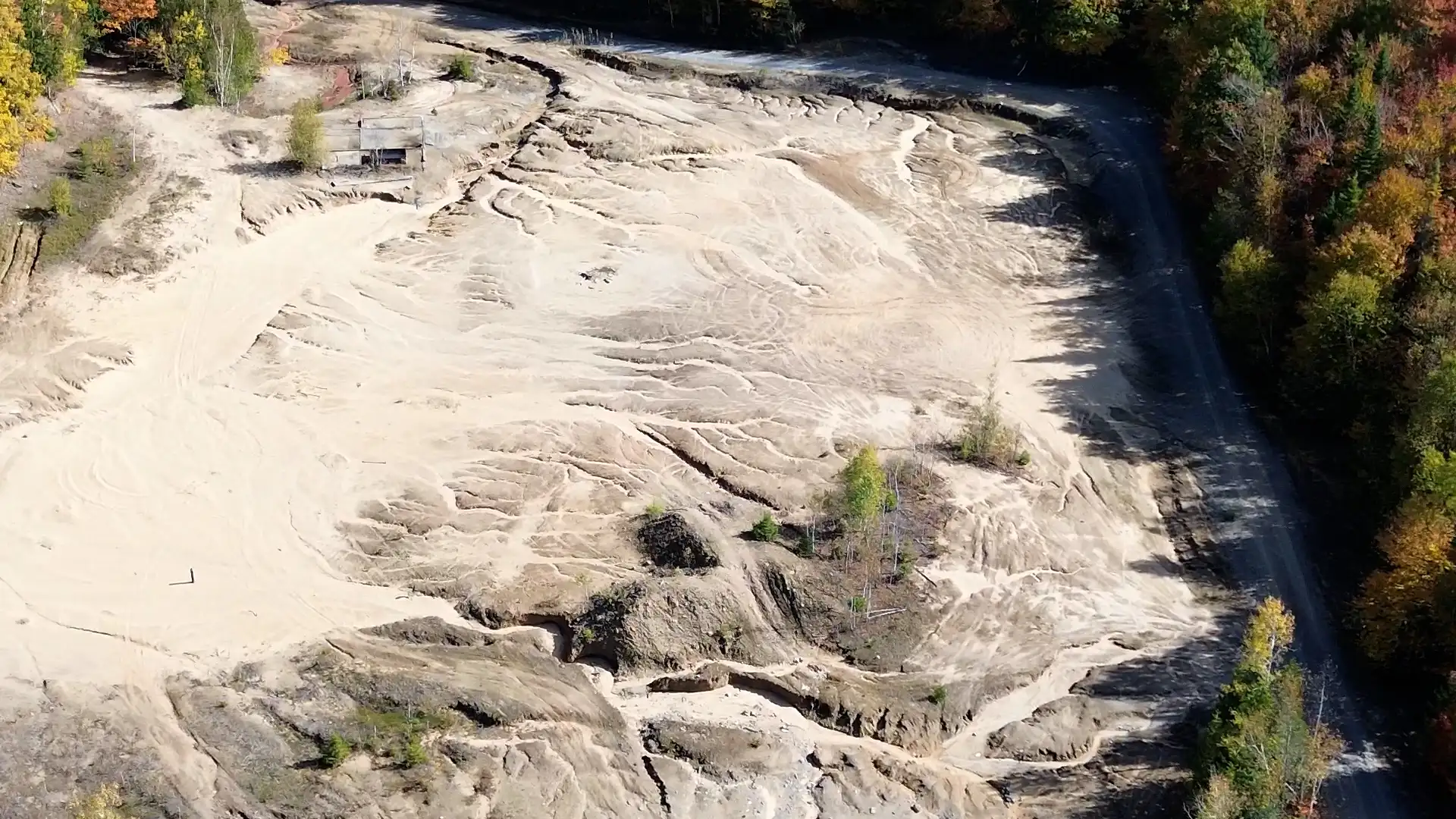

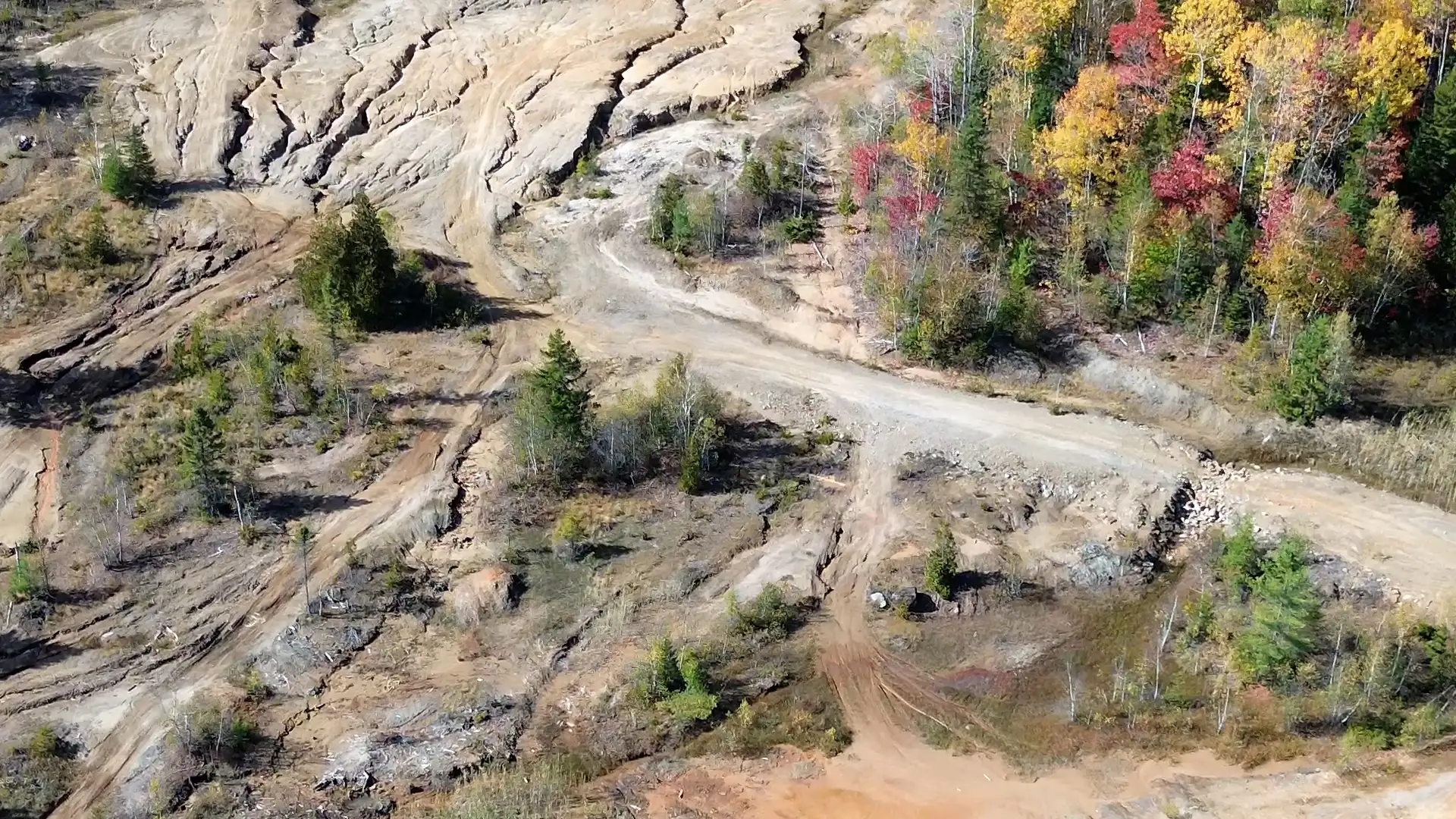

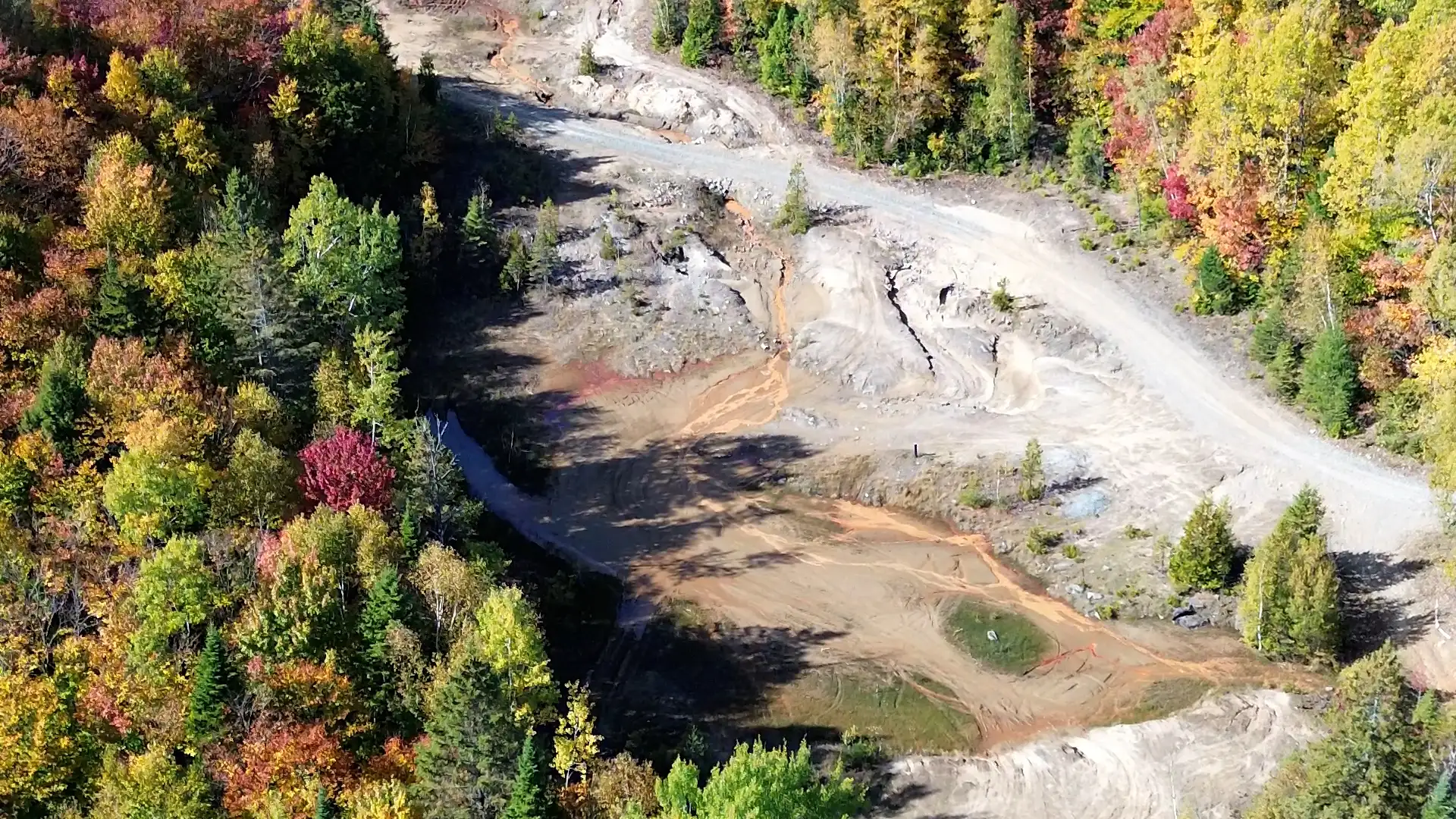

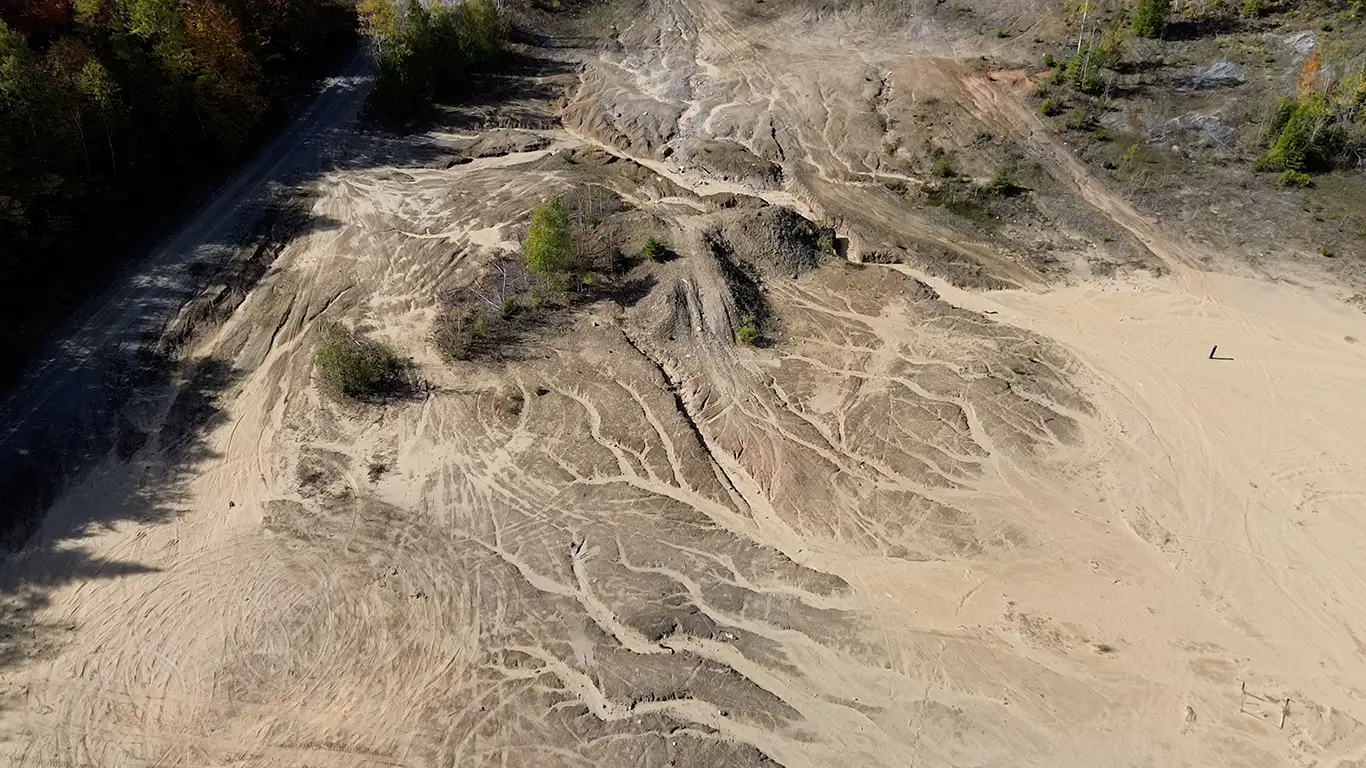

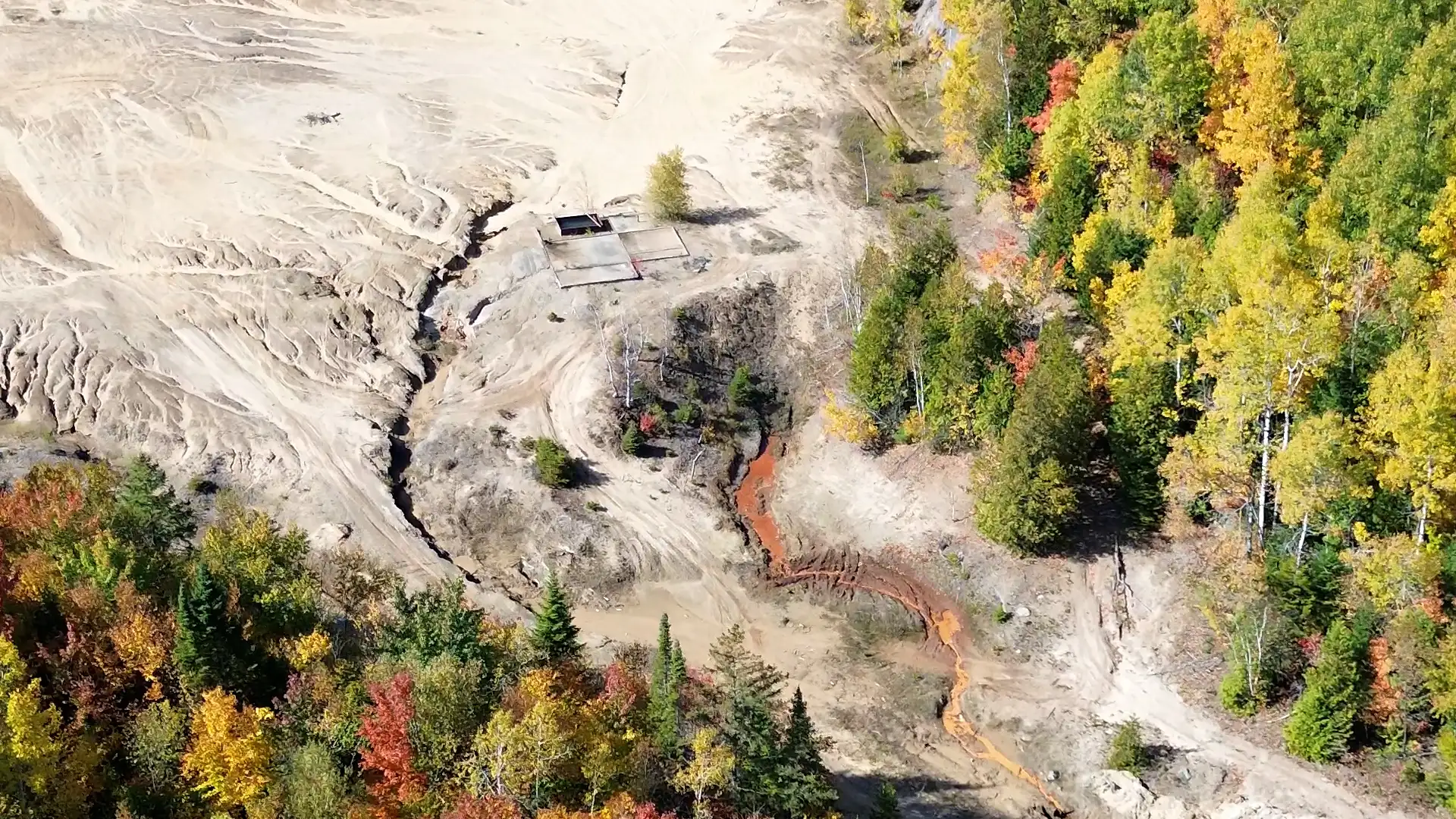

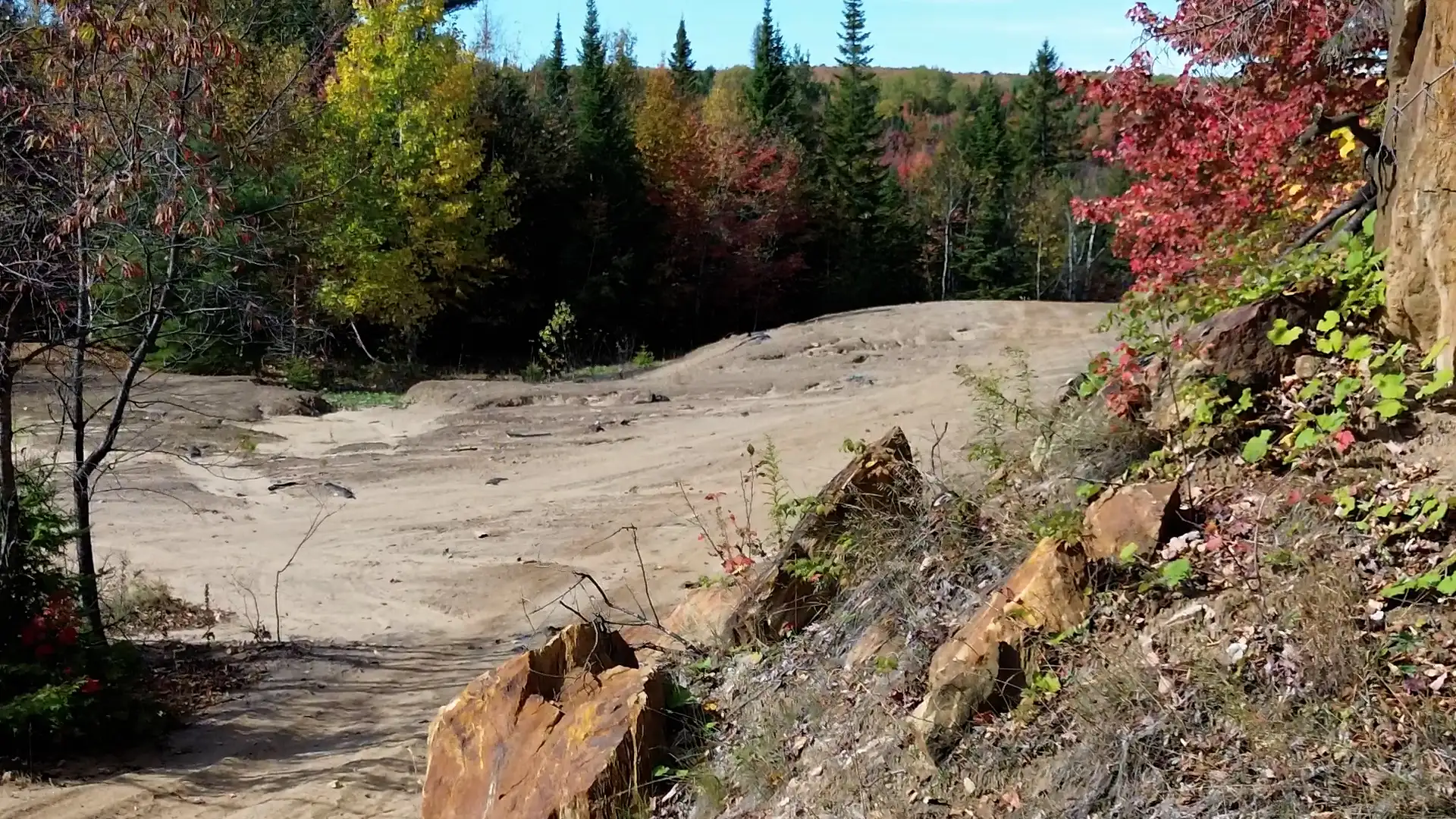

Infrastructure & Construction Status

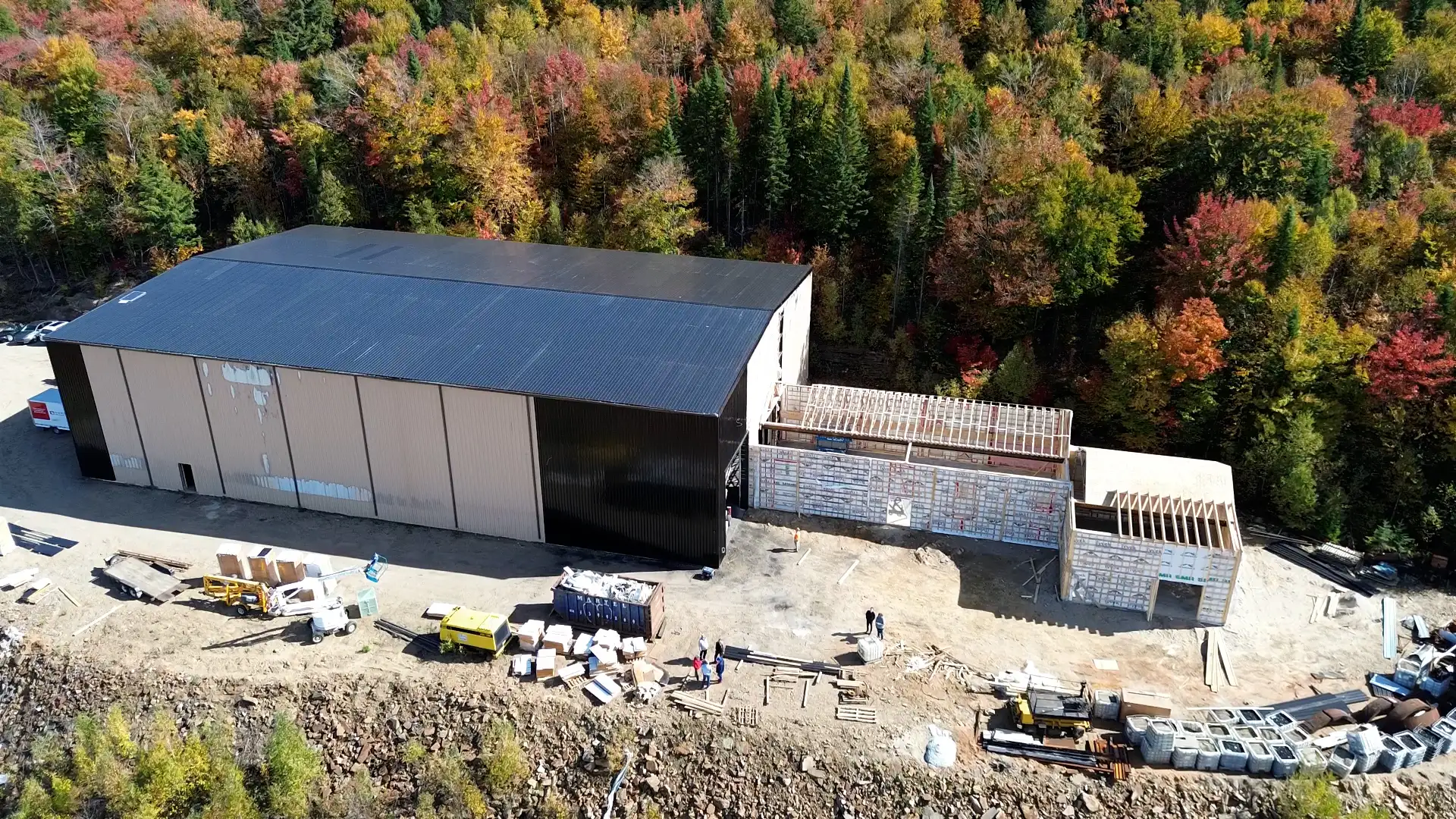

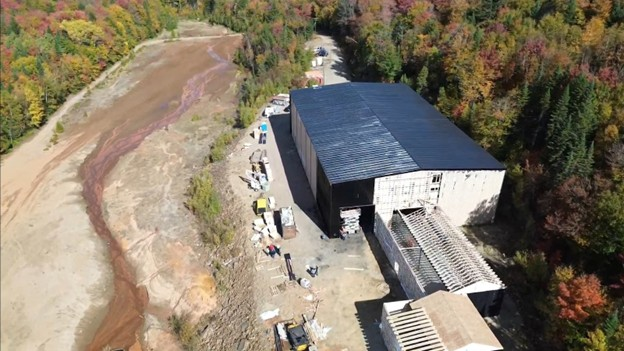

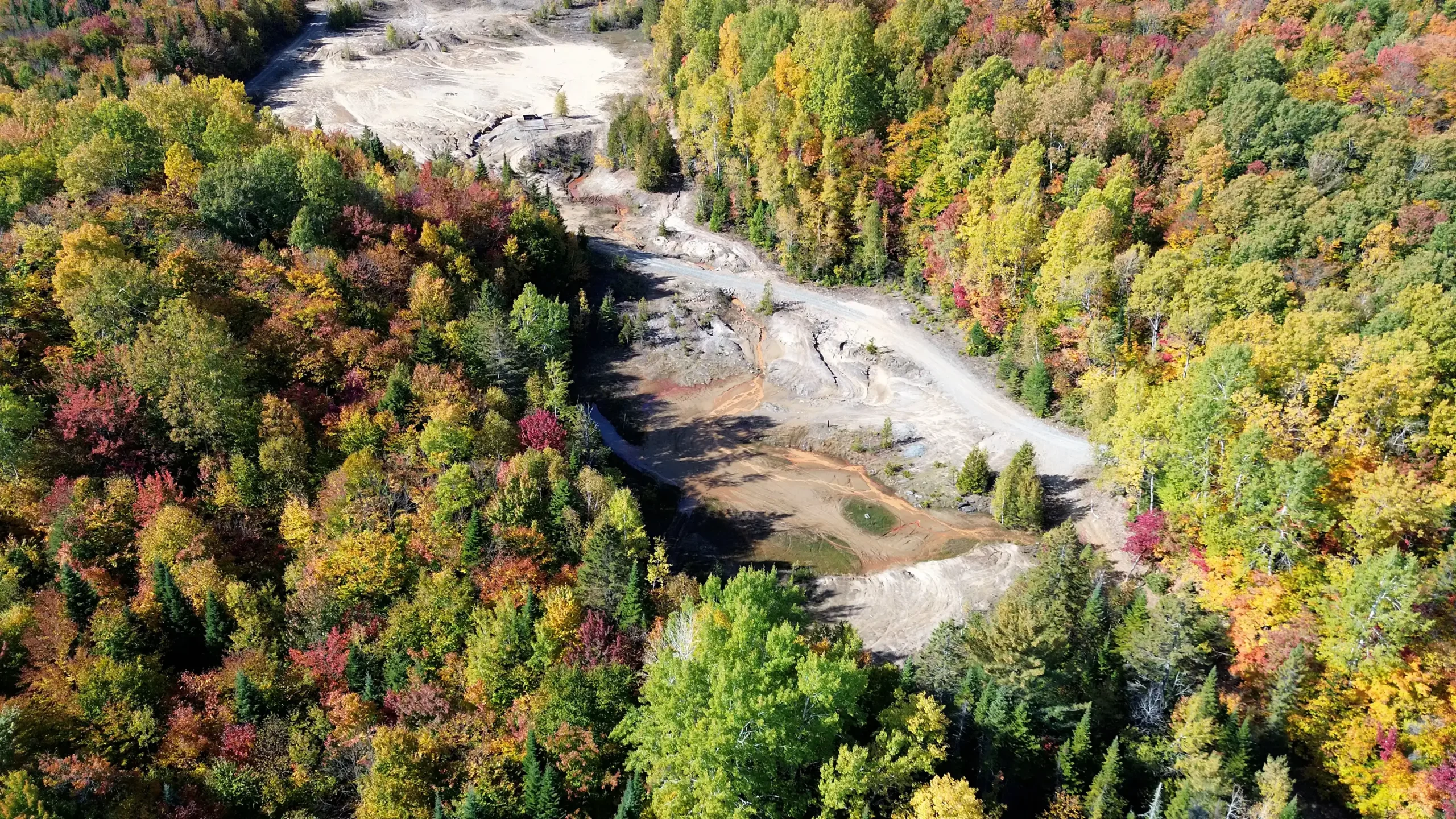

Significant infrastructure has already been installed at Montauban, with commissioning activities now underway.

20,000 sq ft modular processing facility

1.3 km hydropower service line

All-weather road access

Fully permitted construction & operations

On-site laboratory and gold room

Processing plant rated for 1,000 tonnes per day

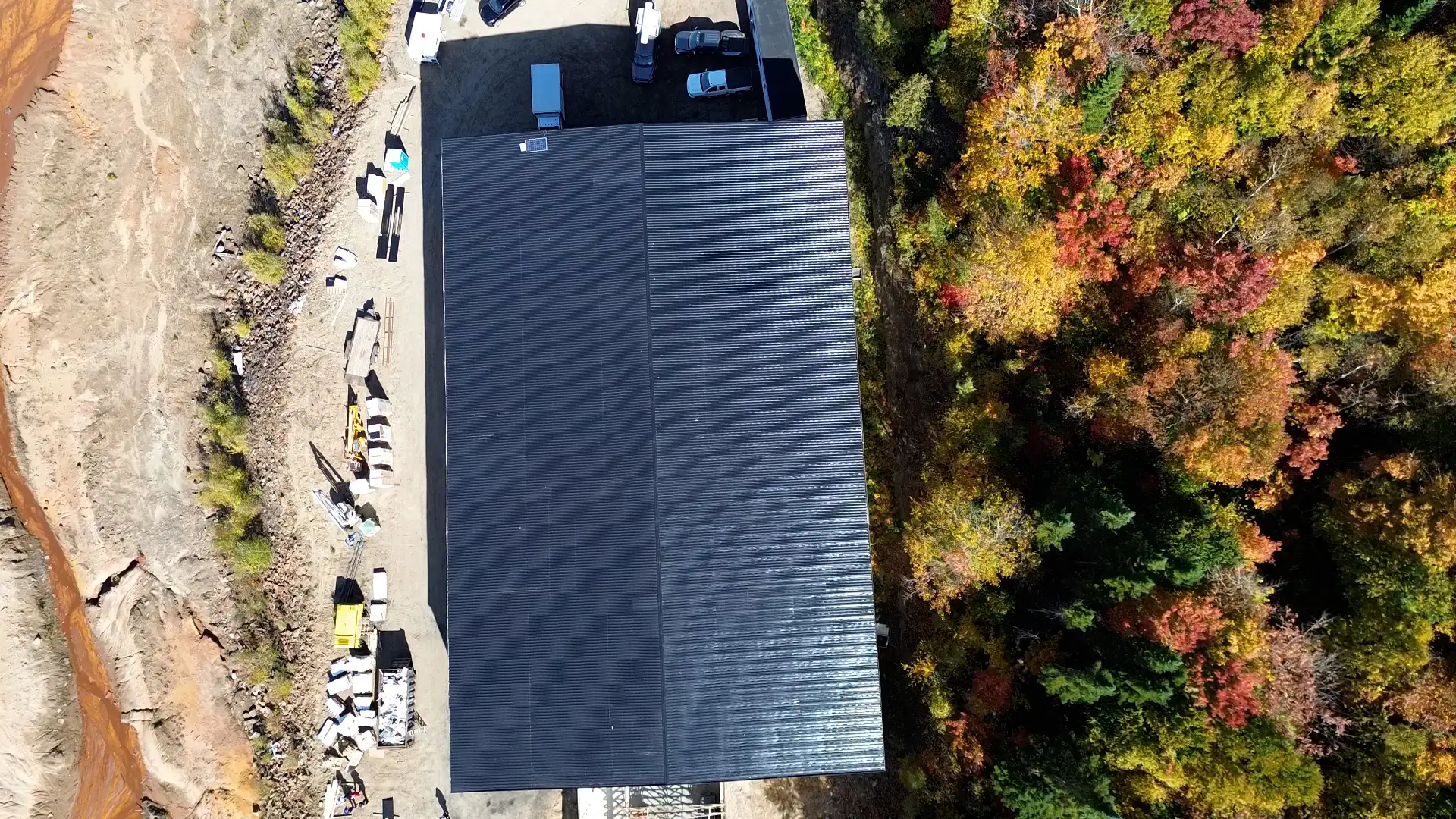

The mill building has been completed, with equipment installation, integration and commissioning activities now underway.To date, ESGold has invested more than $20 million into developing the Montauban project.

MINERAL RESOURCE BREAKDOWN

PROCESSING CIRCUIT

The Montauban processing facility utilizes a Merrill-Crowe recovery circuit, a proven and widely used precious metals processing method.

Mica is separated earlier in the process, creating an additional by-product stream.

01

Screening and separation

02

Grinding

03

Cyanide leaching

04

Clarification & de-oxygenation

05

Merrill-Crowe precipitation

06

Doré production

ECONOMICS

The 2025 PEA demonstrates strong project economics driven by low capital requirements and favorable operating costs.

PEA Highlights

  • 105% pre-tax IRR
  • $44.5M pre-tax NPV (5%)
  • Less than 2-year payback

Price assumptions used in the study

  • Gold: US$2,900/oz
  • Silver: US$32/oz
Current gold and silver prices are materially above the assumptions used in the PEA.

MARKET SHARE PRICES

EXPLORATION UPSIDE

ESGold has completed its expanded Phase 2 Ambient Noise Tomography (ANT-2) survey and updated property-scale 3D geological model at Montauban.

The integrated geological interpretation now covers approximately 70 km² and combines 1,637 drillholes, 1,707 regional multi-element samples, lithology, historical assays, structural interpretation, regional mapping and geophysical data.

ANT-2 used 200 three-component geophone stations and provides useful geological constraint from approximately 86 metres to 1.2 kilometres below surface.

Key observations include:
• Southern and eastern project corridors identified as priority areas for further evaluation
• Northern ANT-2 area remains comparatively under-tested
• Integrated geological, geochemical and geophysical data can now be systematically ranked to guide future exploration targeting

Updated property-scale 3D geological model at the Montauban Project

A 5,000-metre surface diamond drilling program across 29 proposed holes is currently underway, focused primarily on the historic Montauban mine area.

SURFACE PILLAR MINERALIZATION

Historic mining operations left multiple underground pillars containing high-grade mineralization that have not been evaluated using modern exploration methods.

Zone

Tonnes

Au (g/t)

Ag (g/t)

North Zone

274,500

2.80

15

South Zone

114,473

6.10

94

Total

388,973

3.76

38.33

These zones highlight the potential for additional high-grade mineralization within the district.

WHY ESGOLD

DISTRICT-SCALE LAND PACKAGE

Following the new geological model, ESGold expanded its land position to secure structural trends extending beyond the original project boundary.

The Company now controls:

485 MINING CLAIMS

24,414 HECTARES

244 km²

AT A GLANCE

ESG & CIRCULAR MINING MODEL

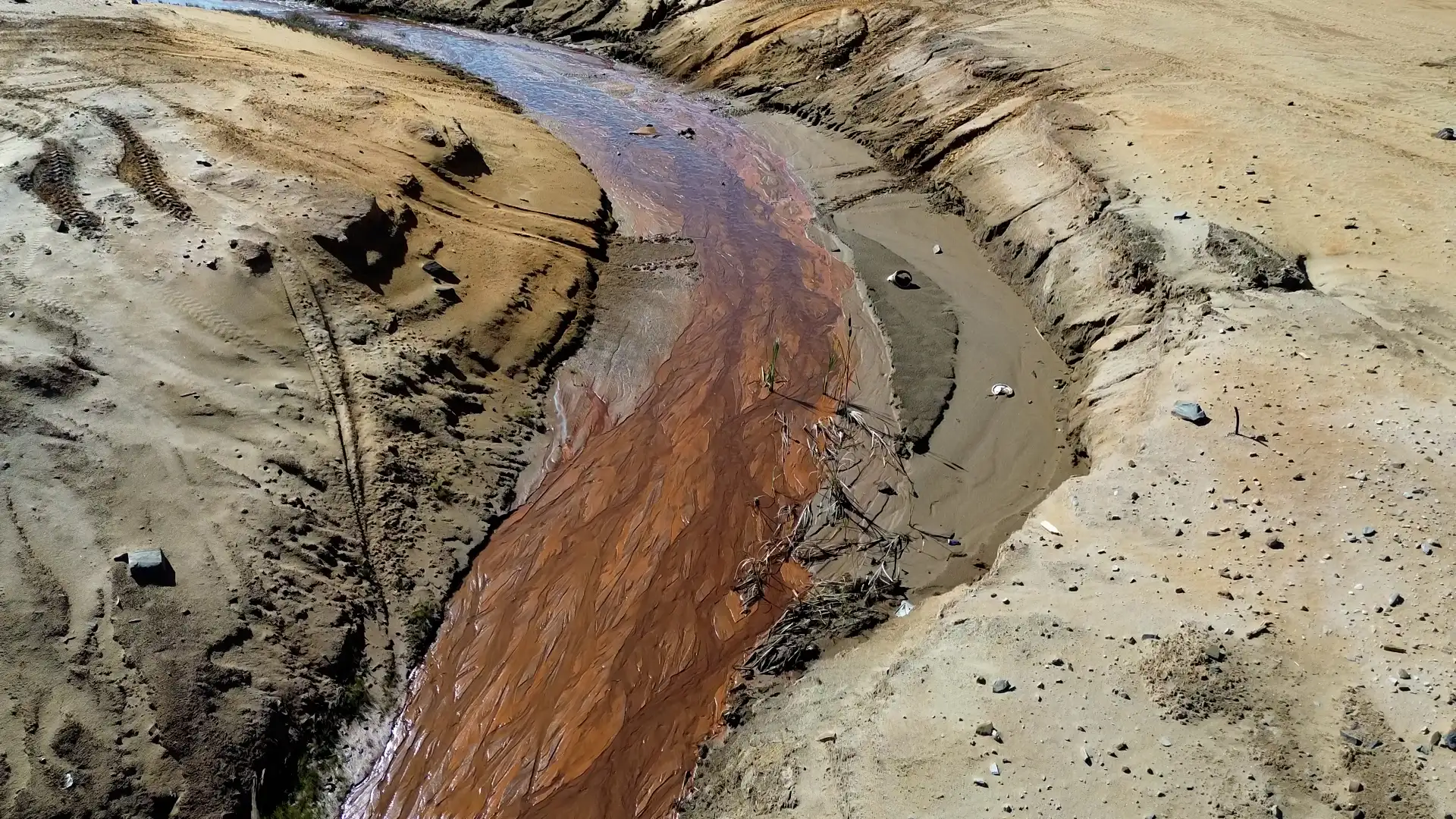

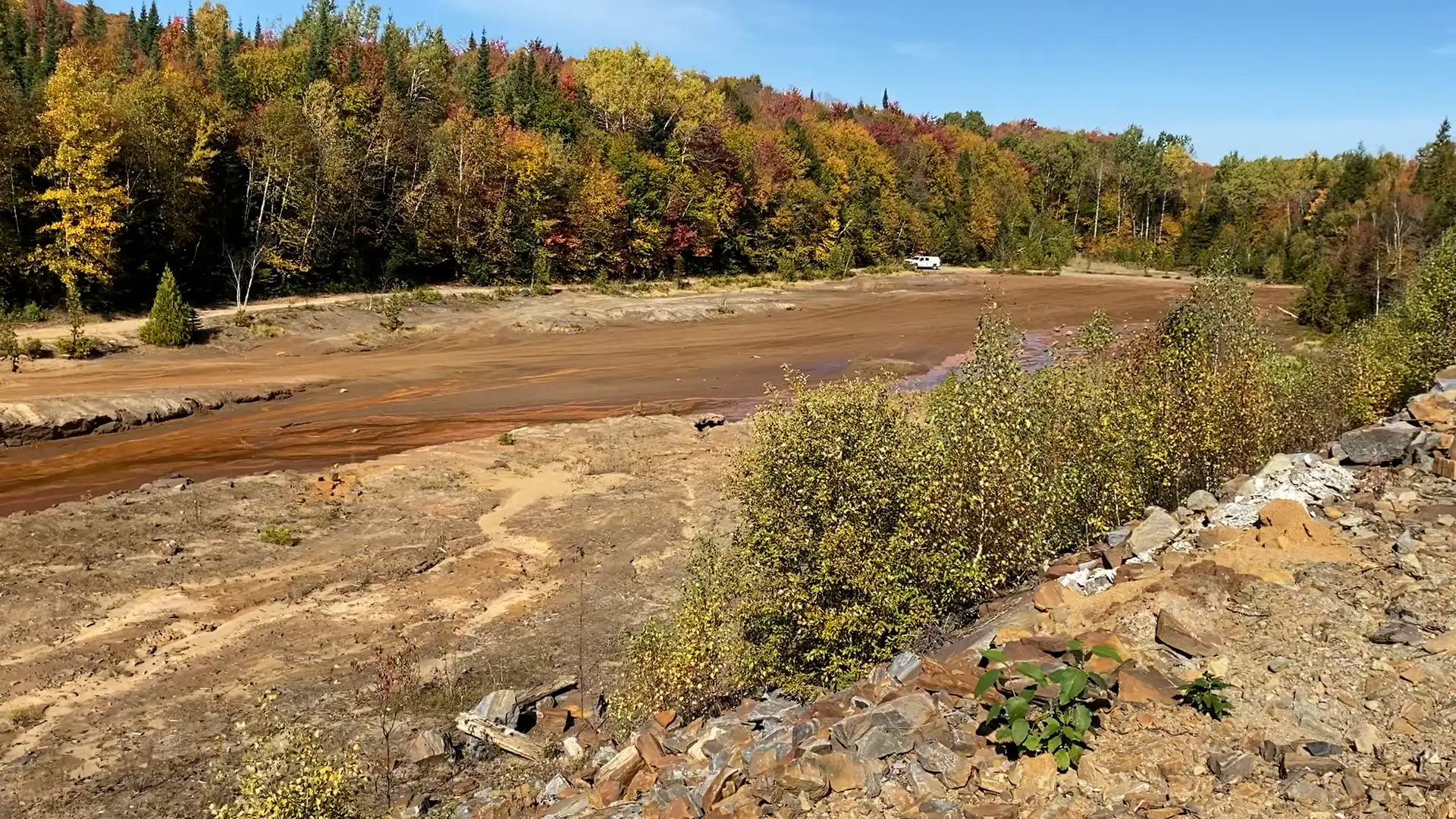

Environmental remediation is a central component of the Montauban project.

The operation is designed to process historic tailings while stabilizing and neutralizing legacy mine waste.

Key ESG benefits include:

Processing historic mine tailings left by earlier operations

Neutralizing and stabilizing
mine waste

Reducing environmental
contamination risk

Repurposing processed tailings into construction materials

Supporting local employment with approximately 30 jobs created

The long-term vision is a zero-waste mine, where historic waste is transformed into valuable products while restoring the site.

PARALLEL PHASE
DEVELOPMENT STRATEGY

ESGold’s development plan follows a two-phase strategy.

01

Phase 1 — Production

Bring the Montauban tailings operation into production and establish recurring cash flow.

02

Phase 2 — Exploration

Use internally generated cash flow to fund district-scale exploration and drill targets identified through geological modelling.This strategy allows ESGold to pursue exploration growth without relying solely on equity financing.

UPCOMING CATALYSTS

Near-term project milestones include:

  • Commissioning updates
  • Processing throughput results
  • Near-term gold and silver production
  • Exploration target ranking from the updated 3D geological model
  • Diamond drilling results and exploration updates

To date, ESGold has completed major development milestones:

01

Over $15M invested into project development

02

All major permits secured

03

Commissioning activities commenced

04

Resource verification completed

05

Metallurgical testing completed

06

Integrated 3D geological model completed

07

Land package expanded following modelling results

PROJECT VIDEOS

3D ANT Survey

ESGold Restores the Land

Montauban 3D Geological Model

LEARN MORE

Montauban combines near-term gold production with district-scale exploration potential.
